LLuxury SuperBlockBGC · 2025–2027
SYNC · LIVE
12:35 PHT
SharePoint · DailyReports
↑ THE HEADLINE · WEEK 49
Watch
Behind plan; corrective actions in progress. Project tracks -0.70% against revised baseline; forecast handover pending data.

Substructure phase. Daily output is sustained by the current contractor mobilisation; watch: LSB-NCR-WECI-007-007 - Space Truss and Weepholes Zero safety incidents this week.

Substructure phase99% completeDay 336 / 2501 contractor delay · Day 3
FORECAST · COMPLETION
TARGET
—
→
FORECAST
—
FORECAST
—
vs current 14-day pace
DAYS OVER TARGET
86of 250 program-days
PROGRESS
99.3%
-0.70%
vs 100.0% planned
VARIANCE
-0.70%
−0.07
vs revised baseline
SAFETY
0
14d streak
incidents this wk · 7 PTD
HSEQ status
This week + project-to-date
SAFETY
Recordable Incident / Accident & Near Miss
THIS WK
0
PTD
7
Closed
QUALITY
NCRs Issued
THIS WK
0
PTD
3
Closed
QUALITY
Progress Inspection Reports
THIS WK
0
PTD
8
For Closing
ENVIRONMENTAL
Environmental Incident
THIS WK
0
PTD
1
Closed
SAFETY
Safety Manhours
THIS WK
0
PTD
59,265
8-hour workday
Progress trajectory · Daily
Plan vs actual + 28-day forecast · 30 reporting points
Actual Plan (rev. baseline) Forecast
95%100%Aug 19Aug 31Sep 11Sep 22
Enabling works · programme
2 of 3 active · Site prep, bulk excavation and slope protection
TODAY · 99%
Site Prep + Mobilization100%
Bulk Excavation — Retail Block99.6%
Slope Protection (5th / 26th)95.8%
Contractor performance
Substructure phase · this week
We Enterprises & Contractors Inc.
Excavation, Slope, Hauling
16/33
CREW
Weather + crew
Heavy Rain, 30°C
30°
Heavy Rain · Hum Very High · Wind 12 km/h
RAIN-DAYS · SEP
16 rain days this month
CREW ON SITE
48% staffed
16of 33 planned
Today's work · vs target
We Enterprises & Contractors Inc. · 16 on site

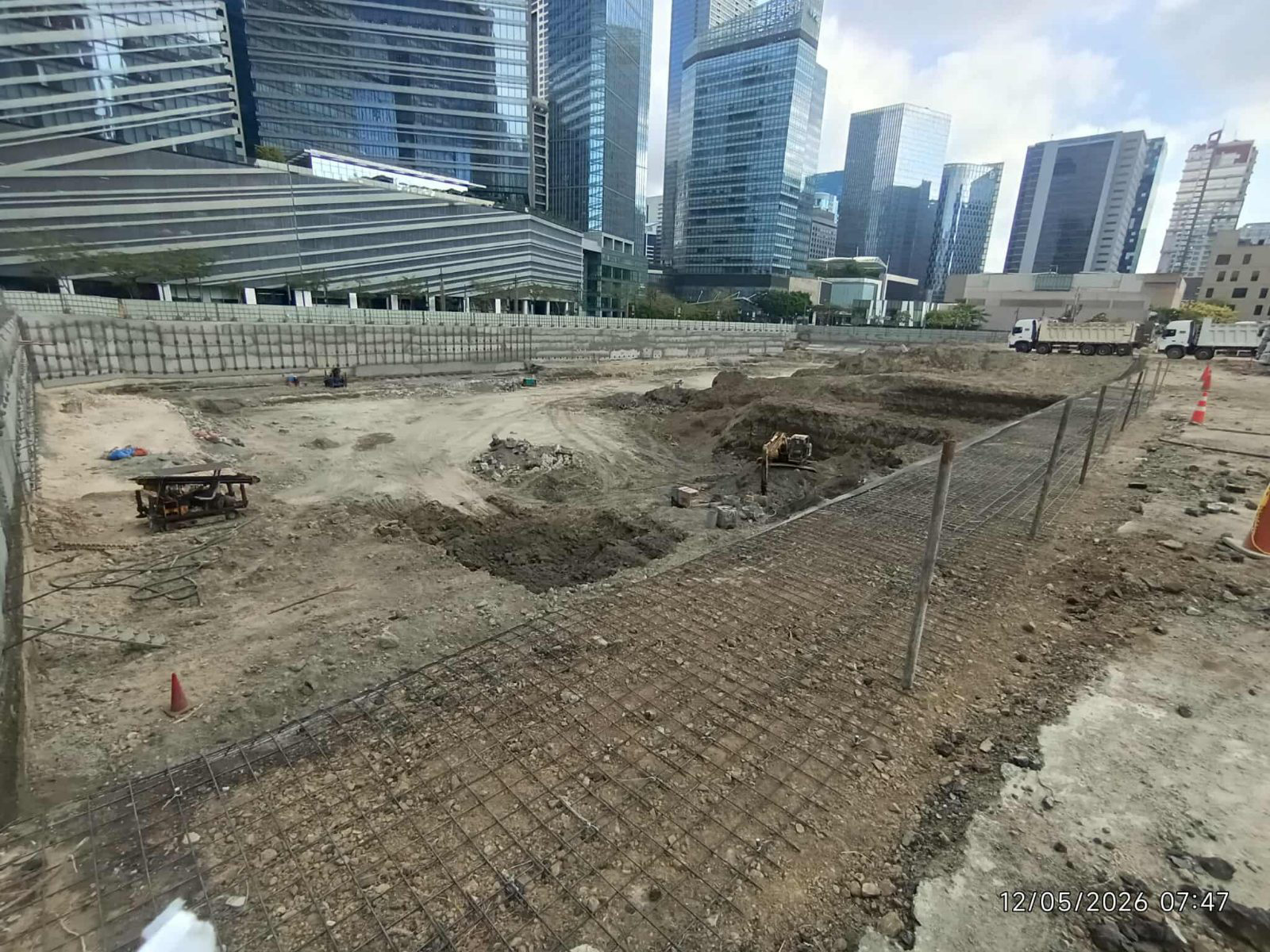

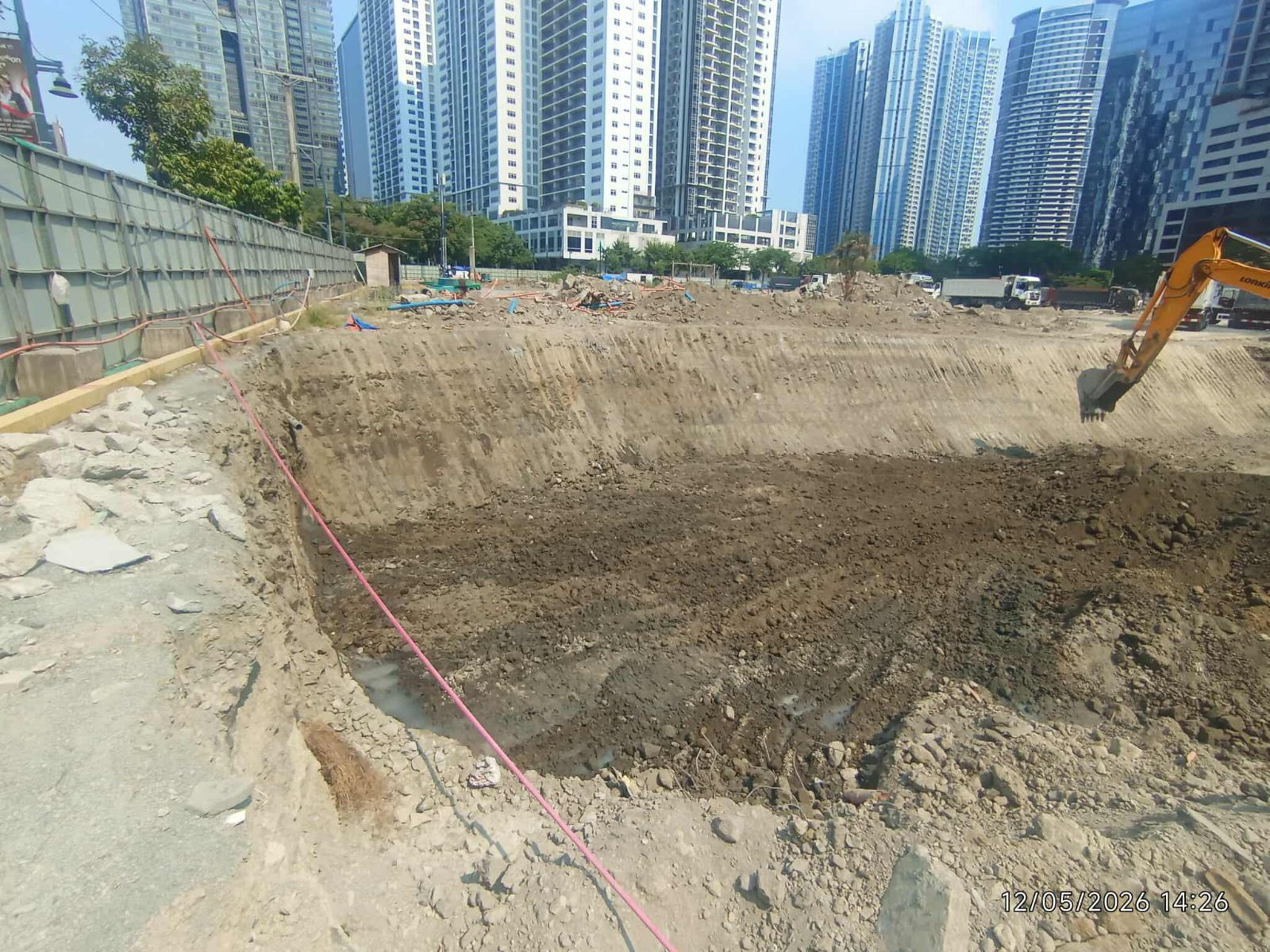

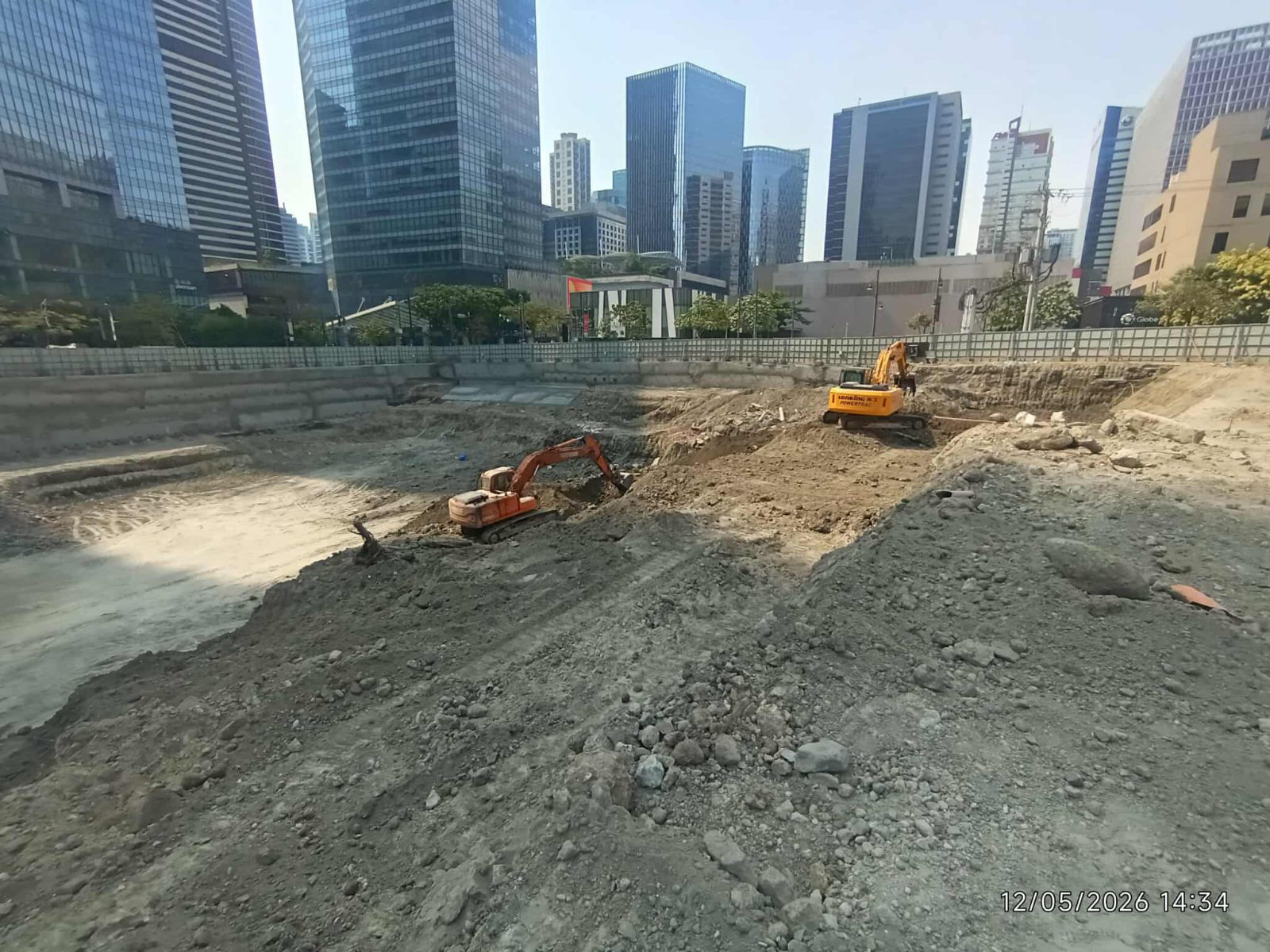

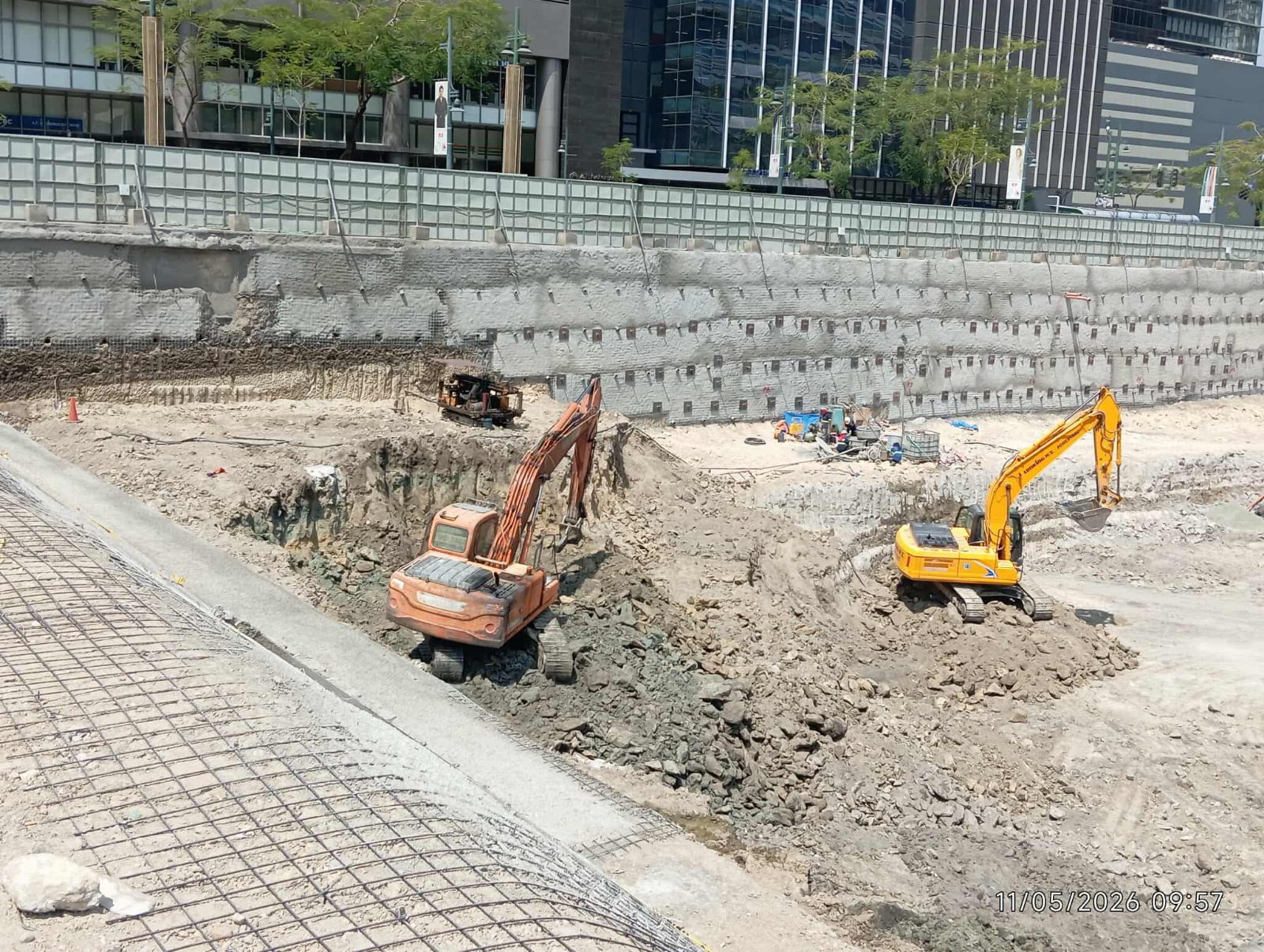

Bulk Excavation of Retail Block (10 meters depth)
tgt 100%100%-0.24%
Slope Protection
tgt 100%100%-0.10%
Horizontal Trimming

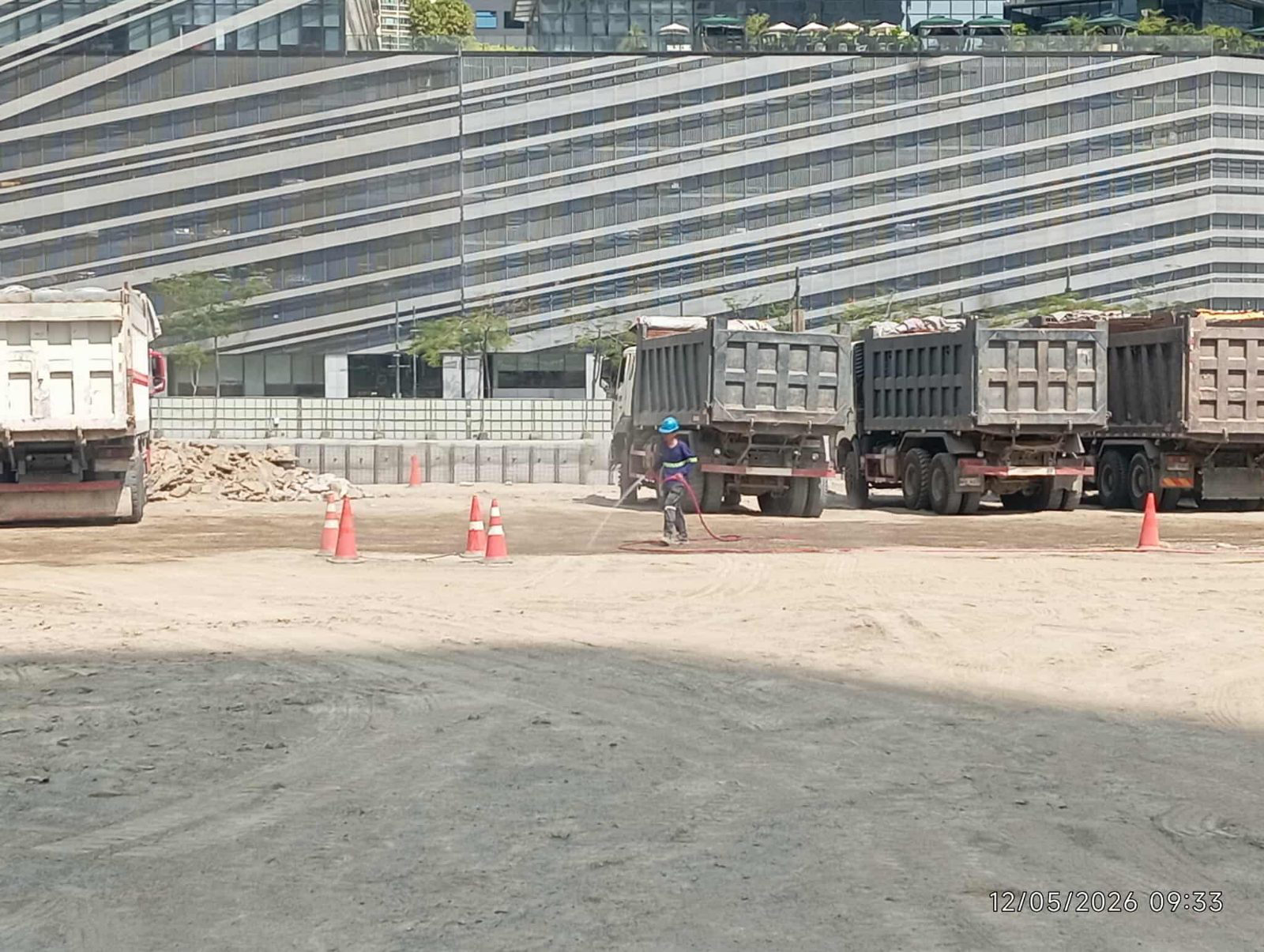

Hauling (78.4 cubic meters)

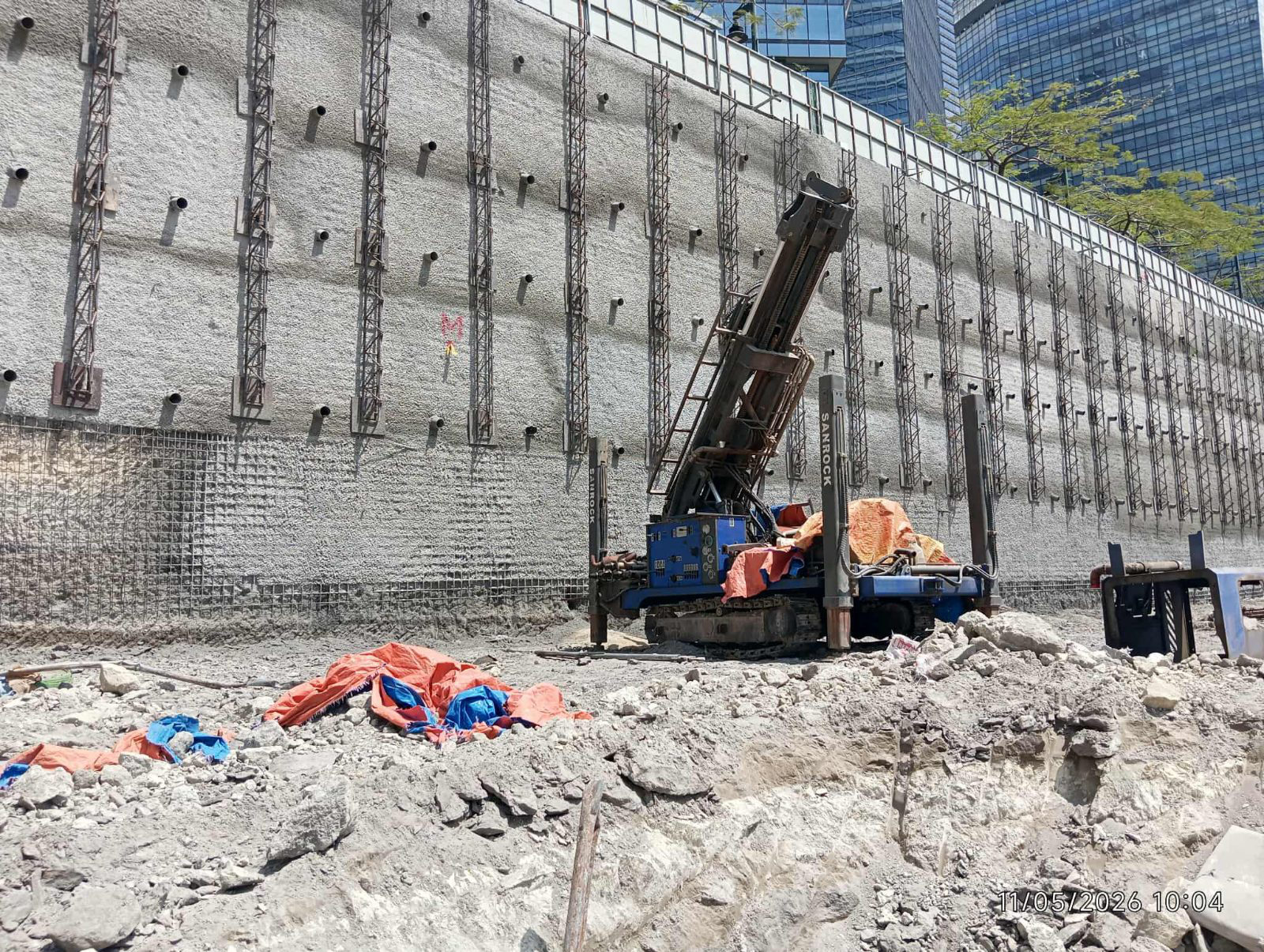

Berm - Drilling, Grouting, Shotcreting, Plate-locking, and Installation of wiremesh

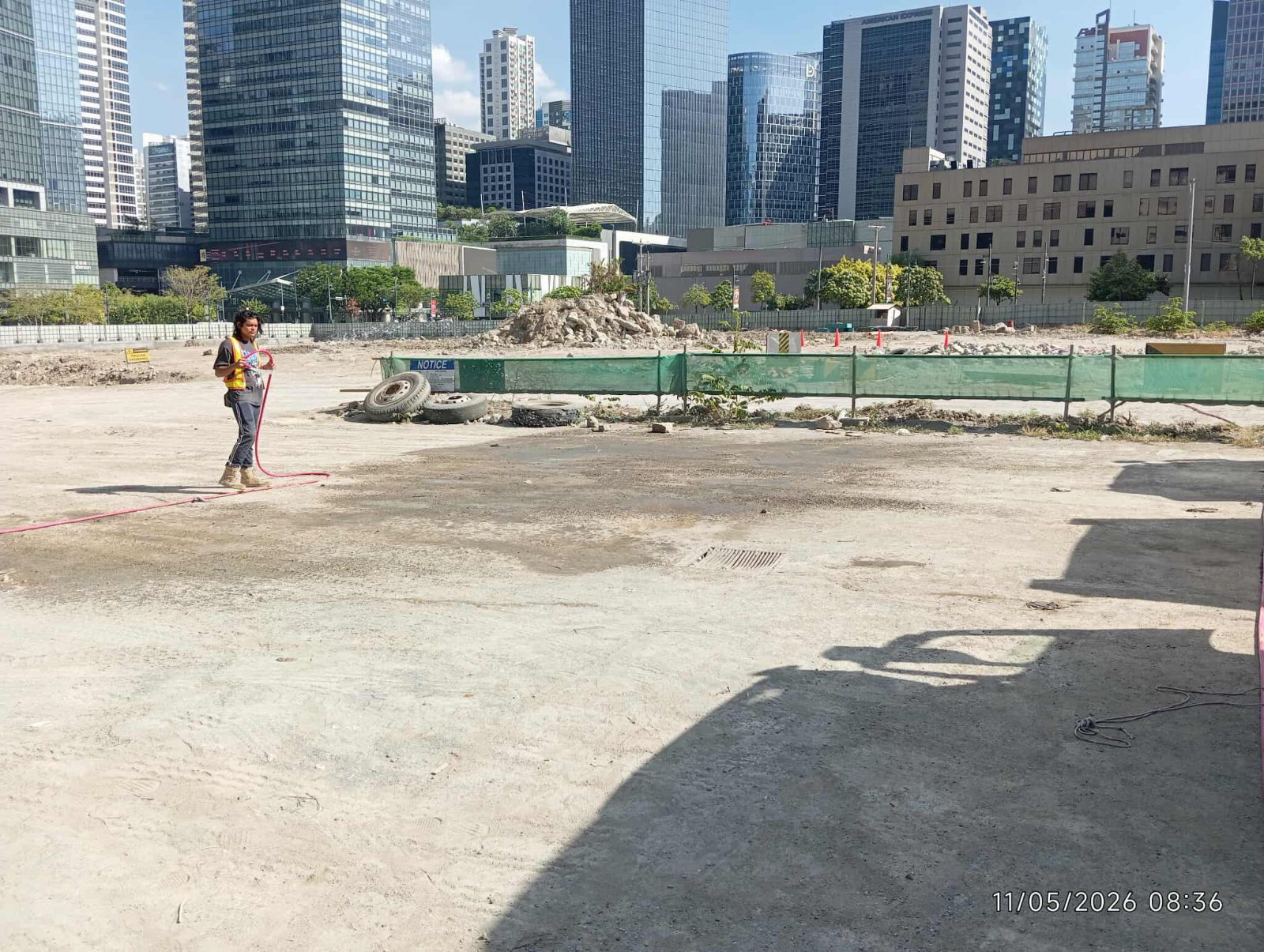

Dewatering - 5 discharge pumps
Risks + open items
Watch-list
LSB-NCR-WECI-007-007 - Space Truss and Weepholes
Watch · open
NCRs open
3
RFIs pending
0
QA / QC open
0
Recent daily reports
Last 7 reporting days
Date
Report
Plan
Actual
Var
Status
Sep 22
DPR-BGC_LUX-2026-021
100.00%
99.30%
-0.70%
Watch
Sep 21
DPR-BGC_LUX-2026-020
100.00%
99.30%
-0.70%
Watch
Sep 19
DPR-BGC_LUX-2026-019
100.00%
99.30%
-0.70%
Watch
Sep 18
DPR-BGC_LUX-2026-018
100.00%
99.30%
-0.70%
Watch
Sep 17
DPR-BGC_LUX-2026-017
100.00%
99.30%
-0.70%
Watch
Sep 16
DPR-BGC_LUX-2026-016
100.00%
99.30%
-0.70%
Watch
Sep 15
DPR-BGC_LUX-2026-015
100.00%
99.30%
-0.70%
Watch
From site, today
14 photos · Tue Sep 22 report
Rectification of Berm
Rectification of Berm
Horizontal Trimming
Horizontal Trimming
Dewatering Setup
Dewatering Setup

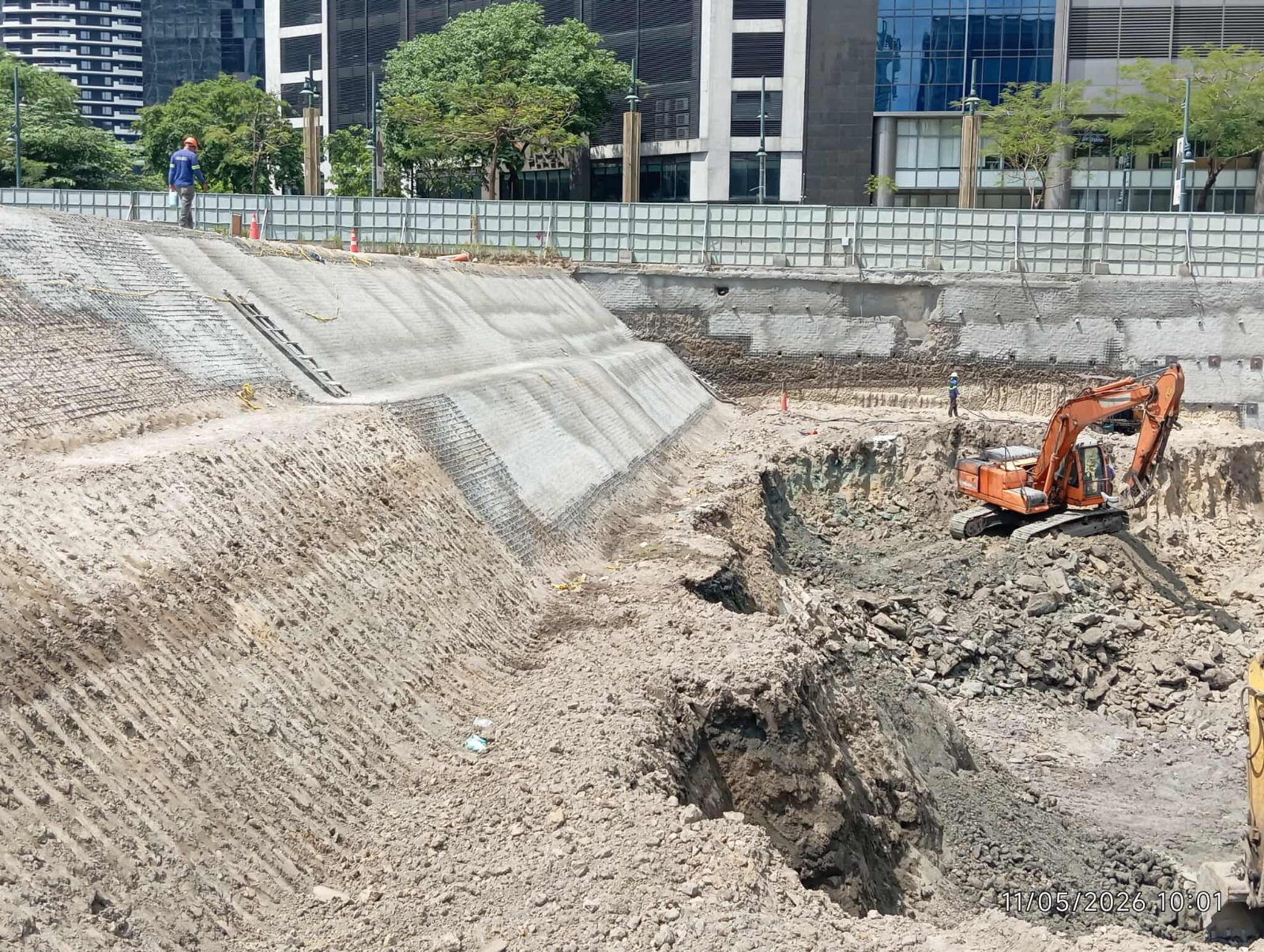

Slope Protection at 28th
Slope Protection at 28th

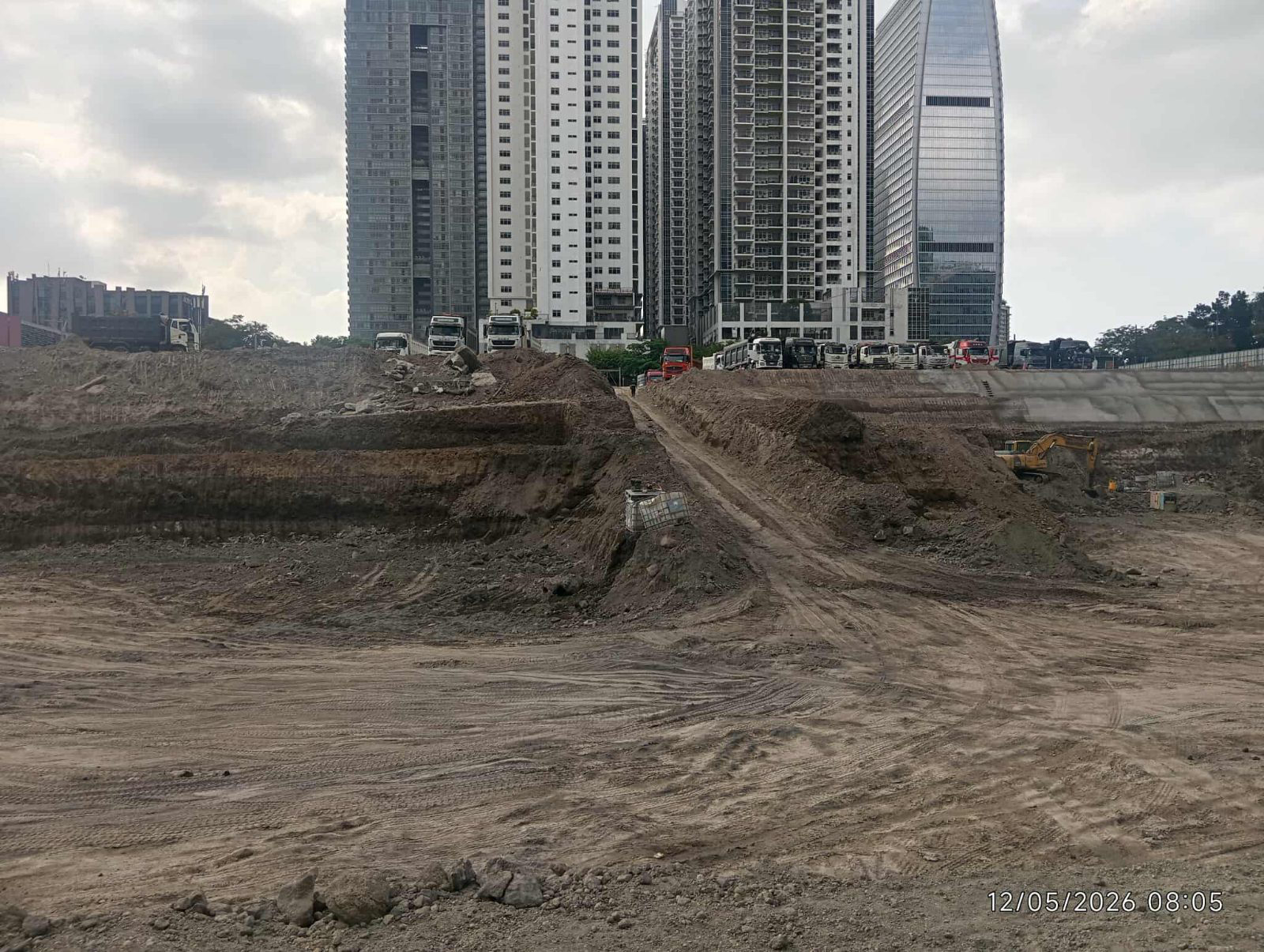

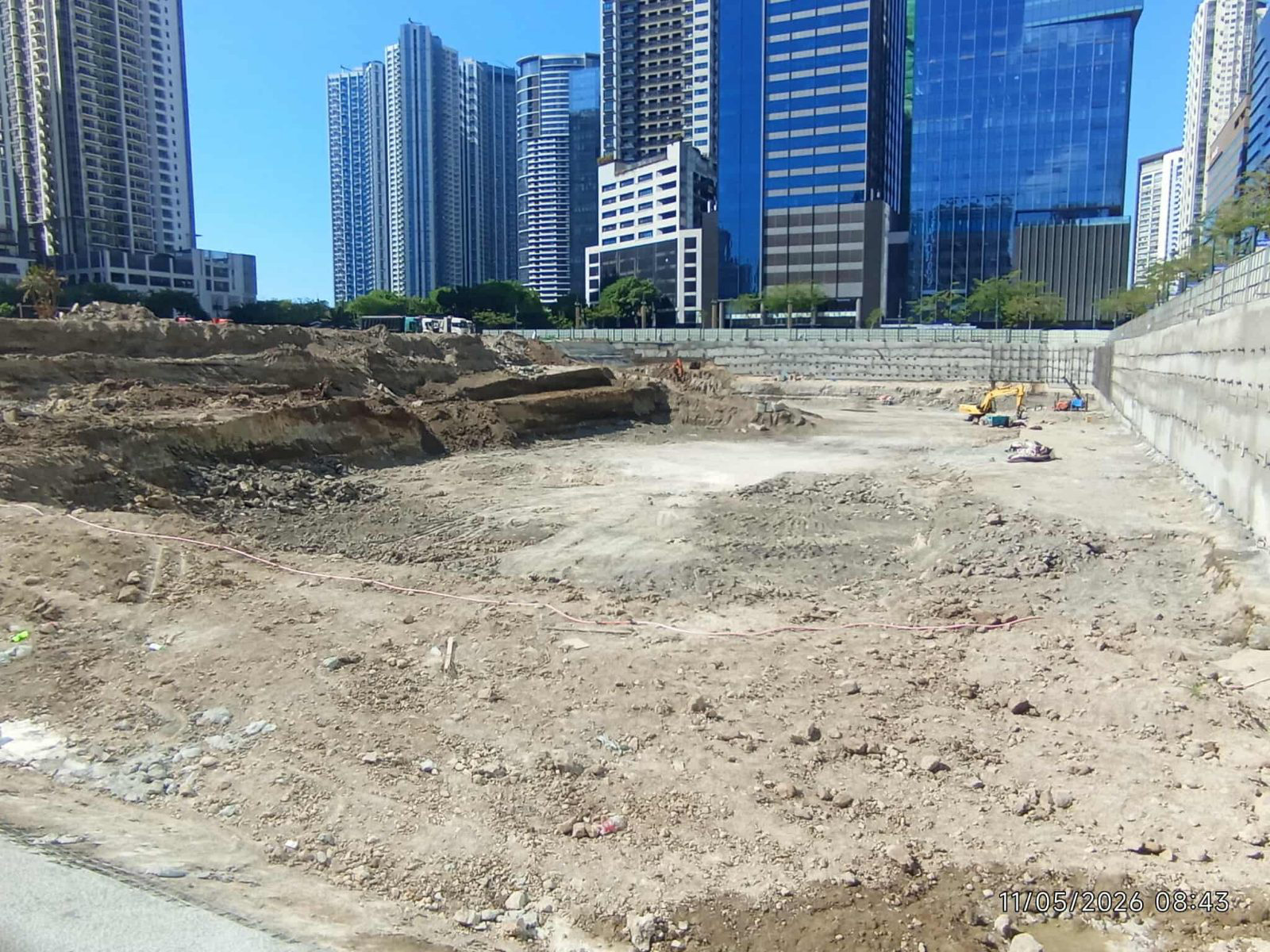

Excavated Area at Slope Protection at 5th cor 28th
Excavated Area at Slope Protection at 5th cor 28th
Shotcreting · berm face
Shotcreting · berm face
Safety railing install
Safety railing install
